Construction commencement of 2nd waste-to-energy plant project in Hanoi, investment capital of 3,500 billion VND

On the morning of March 30, 2022, PECC1 leaders and the company's delegation attended the groundbreaking ceremony for the construction of the Seraphin waste-to-energy plant in Xuan Son, Son Tay, Hanoi. This is the second waste-to-energy project in Hanoi invested by Seraphin Green Environment Technology Joint Stock Company of AMACCAO Group.

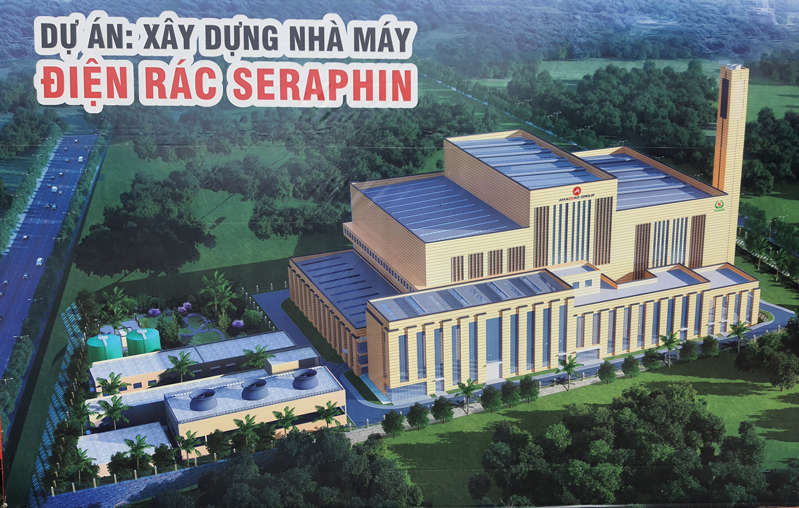

Seraphin waste-to-energy plant with a total investment of 3,500 billion VND is built in Son Tay, Hanoi

The project applies Belgian Segher technology, which is a modern, friendly technology with the environment, originating from Europe with the main quality criteria of emission; the incinerator meets EU 2000/76/EC standards, other indicators all meet and exceed QCVN 61/2016/BTNMT. This technology has been researched and improved with much modern auxiliary equipment, improving the environmental quality in the plant's waste treatment activities, regenerating energy, especially suitable for Vietnam's waste (low heating, high humidity, unclassified). The project aims to develop a high-quality environmental industry; treatment when discharging, wastewater and solid waste to meet the strictest standards and concurrently bring the highest socio-economic efficiency.

At the ceremony, Mr. Nguyen Trong Dong - Vice Chairman of the Hanoi People's Committee - said that the Seraphin waste-to-energy plant is one of the important projects of Hanoi city, with a treatment capacity of 1,500 tons of dry waste per day, the investment capital is 3,500 billion VND.

According to Mr. Dong, this is the second waste-to-energy power plant project in Hanoi, burning waste to reduce the volume to be buried from 100% to 3%. Previously, the Soc Son waste-to-energy power plant was constructed, which is expected to connect to the national power grid in March this year. Together with the Soc Son plant, when being put into operation, Seraphin will basically treat the waste in the city in the direction of burning waste to generate power instead of burying it, considering waste as a resource, for a greener, cleaner city.

Seraphin is one of the important projects of Hanoi city, with the treatment capacity of 1,500 tons of dry waste/day, an investment capital of 3,500 billion VND.

Previously, in June 2020, PECC1 signed a Consulting and Design Contract with the Project Owner on Consulting and Designing for Supplemental to National Power Development Master Plan and preparing the Feasibility Study Report. Scope of work includes:

  • PDP supplement is inclusive of:

+ Planning Seraphin Waste-to-Energy Power Plant to National Power Development Master Plan;

+ Planning 110kV substation connected to the national grid network;

+ Planning transmission line from Seraphin Waste-to-Energy Power Plant to the connection point.

  • FS Report is inclusive of:

+ Carrying out investigation serve for the preparation of FS Report and Technical Design;

+ Preparing FS Report for the plant and transmission line;

+ Preparing specialized reports: Fire Protection Report; Grid Connection and Connection for Power Purchase Report; Relay/Telecommunications/Scada-Ems Protection Report; Environmental Impact Assessment Report; Engineering Geological, Topographical, Hydrometeorological Survey Reports, etc. and other reports and agreements;

+ Preparing Technical Design.

In addition, PECC1 also provides bid evaluation services for the EPC package for plant construction and assists the Project Owner in the EPC contract negotiation process.

Continuing to be trusted by Project Owner increasingly affirms the experience and qualifications of PECC1's engineers, and simultaneously affirms that the Company's financial capacity, facilities, and technology fully meets strict terms and conditions set forth by the Project Owner.

Seraphin Waste-to-Energy Power Plant Project

- Project Owner: Seraphin Green Environment Technology JSC.

- Rated waste handling capacity: 1,500 tons/full day;

- Max. waste handling capacity: 1,650 tons/full day;

- Operation hours: ≥ 8000 hours/year;

- Power generation capacity (Including 03 steam incinerators (the capacity of each incinerator is 500 tons/days): 37 MW (2 units: 01 unit of 25MW, 01 unit of 12MW)

- Occupied area: 2.5ha;

- Expected construction schedule: 16 months

- Total investment cost: About 3,500 billion VND.
